KZ-ARCHITECTURE

Construction Timeline Reality Check: Why Your Phuket Villa Requires a Minimum of 16-18 Months, Not 12

KZ-Archi - Site Analysis

Introduction: The 6 Months That Change Everything About Your Project

Your builder promises a villa delivered in 12 months. The reality I observe every day here in Phuket? A minimum of 16-18 months for a project without major complications.

This difference is not due to incompetence. It reflects the brutal operational reality of villa construction Phuket: the tropical climate, the complexity of the Asian supply chain, the local OBT (local administration) procedures, and technical constraints no one mentions when signing the contract.

After 20 years of international architectural practice and 12 years of experience in Asia, managed by our Architecture Firm in Phuket, I have decided to be completely transparent.

Our commitment: foundations based on Eurocodes/ACI standards, not on marketing promises. Here is the factual breakdown of the real timelines for a villa construction timeline Phuket of 300-650 sqm — and why accepting this truth is the first step to saving time, money, and stress. If you are unsure of the real value and cost of this initial stage, you should read our full guide on What You’re Actually Paying For.

Completed luxury villa Phuket with a 16-18 month realistic construction timeline KZ Architecture
Completed luxury villa Phuket with a 16-18 month realistic construction timeline KZ Architecture

Why Builders Announce 12 Months (and Why We Don’t)

The promise “12 months from groundbreaking to key handover” rests on three assumptions, which I call “wishful thinking”:

  1. Building Permit Already Obtained: The count starts after the permit is secured. However, this administrative phase takes an additional 6 to 12 weeks.
  2. Ideal Weather Conditions: The schedule assumes no interruptions due to monsoon rains (May to October). I have observed that in reality, 3 to 4 weeks of work are lost every year due to weather conditions.
  3. No Supplier Delays: The calendar assumes all materials and equipment arrive exactly on the scheduled date. Experience shows supply delays of 2 to 6 weeks, or more, for imported or custom products.

Result: The “12 months” mechanically becomes 16-18 months as soon as these real Thailand building timeline variables are integrated. The result is often compromised quality and major delays, confirming our analysis that Free Design from Contractors Costs You More in the long run.


The Reality Schedule: 16-18 Months to Build Your Quality Villa in Phuket

Here is the factual timeline for a contemporary 350 sqm villa in Phuket, from bare land to final delivery.

Phase 1: Feasibility and Design (10 weeks)

  • Weeks 1-2: Preliminary Studies: Topographical survey, mandatory geotechnical analysis, local zoning code verification.
  • Weeks 3-8: Architectural Design: Detailed plans, structural and MEP engineer coordination.
  • Weeks 9-10: Permit Documentation: Preparation of the complete file.

Actual Duration: 10 weeks (if client is responsive).

Phase 2: Obtaining the Building Permit (8 weeks)

This phase is the most critical for the Phuket villa construction time.

  • Critical Variable: The delay depends on the completeness of the file and compliance with standards managed by the Local Administrative Organization (Or Bor Tor – OBT).
  • Average Observed Delay: 6-8 weeks to obtain the Construction Authorization (Sor Kor 1) on standard land.

    For official information on Thai building regulations, consult the Department of Public Works and Town & Country Planning.

Challenging terrain conditions typical in Phuket requiring specialized foundation work
Challenging terrain conditions typical in Phuket requiring specialized foundation work

Actual Duration: 8 weeks (standard project).

Phase 3: Site Preparation (4 weeks)

Installation of logistics base, earthwork, and leveling.

Actual Duration: 4 weeks

Phase 4: Foundations and Structure (14 weeks)

The shell structure, critical for the durability of your villa construction Phuket.

CRITICAL PHASE: This phase requires technical rigor—Eurocode 2 standards for solidity—is non-negotiable. Any acceleration here compromises the villa’s lifespan.

  • Weeks 1-3: Foundations: Excavation, rebar, concrete pouring. Beware of hard rock or the marshy/clay soils common near Chalong and Rawai which may require additional piling.
  • Technical Note: Although concrete reaches optimal strength in 28 days, we manage the curing process so as not to paralyze the site, removing shoring and starting the next level after 7 to 10 days, depending on the load.
  • Weeks 4-14: Structure, Slabs, and Roofing: Reinforced concrete posts, beams, slabs, and waterproof roofing.
  • Monsoon Impact: Budget an extra 2-3 weeks of accumulated delays if this phase falls during the peak rainy season (May–October).

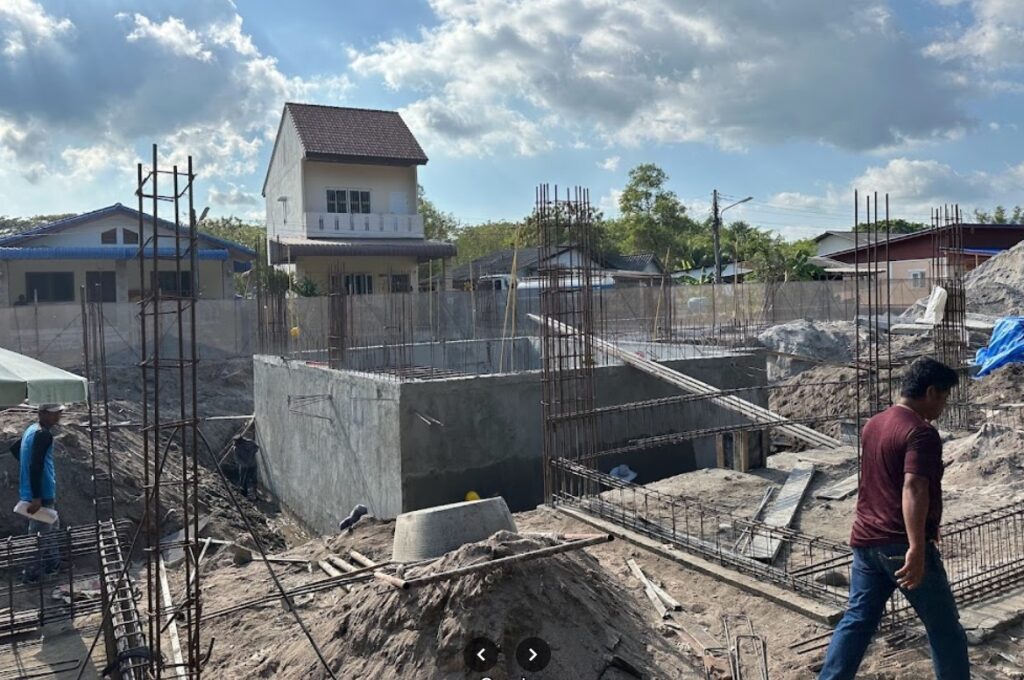

Structural foundation work: Eurocode 2 standards for tropical climate durability
Structural foundation work: Eurocode 2 standards for tropical climate durability

Actual Duration: 14 weeks (excluding complications).

Phase 5: Secondary Work and Finishes (18 weeks)

The longest phase of your realistic construction schedule Thailand.

  • Weeks 1-6: Closing and Systems:
    • Exterior joinery (windows/doors)
    • Plumbing and drainage systems
    • Electrical wiring and panels
    • Air conditioning installation
  • Weeks 7-14: Interior Finishes:
    • Partitions and acoustic insulation
    • Plastering and painting (2-3 coats + drying time)
    • Floor and bathroom tiling
    • Interior joinery (closets, doors)
  • Weeks 15-18: Equipment:
    • Sanitary fixtures (bathtubs, showers, toilets)
    • Fitted kitchen installation
    • Home automation systems
    • Lighting fixtures and switches

Actual Duration: 18 weeks

Phase 6: Exterior Landscaping (7 weeks)

  • Terraces and pool decks
  • Irrigation systems
  • Landscape planting
  • Final fencing and gates
  • Exterior lighting

Actual Duration: 7 weeks

Phase 7: Final Finishes and Handover (5 weeks)

  • Snagging list and corrections
  • Final cleaning
  • Testing and commissioning (AC, pool, home automation)
  • Final Electrical Connection: This administrative step depends on the PEA (Provincial Electricity Authority) and can introduce an unavoidable administrative delay of 6 to 10 weeks that we must budget for.
  • Final inspection and reserve lifting
  • Handover of documentation (as-built plans, warranties)

Actual Duration: 5 weeks


Realistic Total: 66-78 weeks = 16-18 months

Phase Base Duration (weeks) With Contingencies (weeks)
Design and Permit 18 20-22
Site Preparation 4 4-5
Foundations and Structure 14 16-17
Secondary Work and Finishes 18 20-22
Exterior Landscaping 7 7-8
Final Finishes and Handover 5 5-6
TOTAL Villa Construction Timeline Phuket 66 weeks (15.2 months) 72-80 weeks (16.5-18.5 months)

Understanding the Timeline:

  • Base Duration (66 weeks): Optimal conditions with no delays, all materials on time, perfect weather, responsive client decisions.
  • Realistic Duration (72-80 weeks): Includes mandatory contingencies: monsoon delays (2-3 weeks), supplier lead times (2-4 weeks), PEA electrical connection (6-10 weeks typically concurrent with other work but can extend timeline), client decision time, minor site discoveries.

Factual Conclusion: The 16 months minimum represents excellent project management with controlled delays. The 18 months accounts for typical real-world contingencies that occur on most projects. Promising 12 months ignores these operational realities entirely.


7 Factors That Add 2-6 Months to Your Villa Construction Timeline

1. Design Changes During Construction

Each plan modification after work begins generates between 1 and 4 weeks of delay + cost overruns of 15-40% on modified elements.

Concrete Example: Moving a bathroom after slab pouring = reworking plumbing, waterproofing, tiling. Cost: 180,000 THB. Delay: 3 weeks.

2. Material Supplier Delays

High-end or specific products (natural stone, Italian tiles, designer fixtures) require import lead times of 6 to 10 weeks.

Solution: Order long lead-time materials during the design phase, before obtaining the permit.

3. Monsoon and Non-Working Days

Phuket Data 2020-2024:

  • 35 to 45 days of intense rain annually making the site impracticable
  • 15 Thai public holidays
  • ~50 days lost annually due to weather/holidays

Real Impact: Over 12 theoretical months = 7 weeks lost minimum.

4. Site Discoveries

During earthwork: unexpected water tables, hard rock requiring blasting, unstable soils requiring reinforced foundations.

Frequency: 1 in 4 projects encounters geotechnical complications. Additional delay: 2-5 weeks.

5. Coordination Between Trades

Poor synchronization plumber/electrician/plasterer = successive interventions instead of simultaneous.

Common Cause: Absence of coordinating architect. “All-in-one” builders underestimate this complexity.

6. Quality Controls and Rework

On projects without regular architectural supervision: 8 to 12 weeks lost in rework of defects detected late.

Example: Defective terrace waterproofing discovered after tiling = complete removal + redo system. Delay: 4-6 weeks.

7. Energy Supply Connection

Definitive electrical connection by PEA (Provincial Electricity Authority): 6-10 weeks of incompressible administrative delay after application.


The Real Cost of Unanticipated Delays

Comparative Scenario: 400 sqm Villa – 15M THB Budget

Option A: “Optimistic” 12-Month Schedule

  • Builder promises 12 months
  • No safety margin integrated
  • Cumulative delays: 6 actual months

Financial Consequences:

  • Additional temporary rental 6 months: 360,000 THB
  • Current lease delay penalties: 200,000 THB
  • Construction credit financial charges: 150,000 THB
  • Stress + administrative back-and-forth: priceless

Total Impact: 710,000 THB (4.7% of project budget)

Option B: Realistic 16-18 Month Schedule

  • Calendar based on factual experience feedback
  • Margins integrated for weather/supplier contingencies
  • Delivery compliant with schedule

Financial Consequences:

  • No delay-related cost overruns
  • Temporary rental correctly budgeted from the start
  • Zero surprises

Real Savings vs Option A: 710,000 THB


How to Minimize Delays (Without Sacrificing Quality)

1. Engage an Architect When Buying the Land

Time Saved: 4-8 weeks

Identifying regulatory, topographical, and technical constraints upstream avoids unpleasant surprises during the design phase.

2. Approve Material Choices Before Construction Starts

Time Saved: 3-6 weeks

Selecting tiles, fixtures, joinery during the detailed plan phase allows ordering before even excavation begins.

3. Schedule Construction Outside Peak Monsoon Period

Time Saved: 2-4 weeks

Starting foundations in November-December (dry season) rather than June maximizes favorable weather windows.

4. Provide Regular Architect Coordination

Time Saved: 6-10 weeks

Weekly site visits = early detection of non-conformities = immediate corrections vs massive rework at end of construction. This is the essence of our work process at KZ Architecture.

5. Contractualize Supplier Delay Penalties

Time Saved: Variable

Financial incentive clauses in material contracts = respect for delivery deadlines.


Case Study: Surin Villas Phuket

Real Project Timeline Breakdown

Project: Two contemporary modern villas, 650 sqm each
Location: Surin Beach area, Phuket
Construction Start: March 2026
Planned Delivery: September 2027 (18 months)

Why 18 months for a larger project? Larger properties require more complex coordination but benefit from economies of scale and parallel workflows that optimize certain phases.

Detailed Timeline:

  • Design phase: 10 weeks (September-November 2025)
  • Permit application and approval: 8 weeks (November 2025-January 2026)
  • Execution plans finalization: 6 weeks (January-February 2026)
  • Builder selection and contracts: 2 weeks (February 2026)
  • Construction: 18 months (March 2026 – September 2027)

Total Pre-Construction: 26 weeks (6 months)

Planned Risk Mitigation Factors:

  • Dry season start = foundations and structure during optimal weather (March-October)
  • High-end materials (imported stone, custom joinery) ordered 4 months in advance
  • Weekly architectural coordination contractualized throughout construction
  • 6-week buffer integrated for supplier contingencies and client decisions
  • Premium Surin location: enhanced drainage systems due to proximity to beach, specialized foundation work for sandy soils
  • Two-villa project allows parallel workflows reducing per-villa timeline by 8-10%

Why 18 months and not 12? Because we refuse to promise an unrealistic calendar that generates frustration and cost overruns. The Surin clients accepted this factual schedule understanding it protects their budget and peace of mind. For 650 sqm luxury residences with imported finishes, 18 months represents excellent execution.


Frequently Asked Questions

Can you really deliver a villa in 12 months in Phuket?

Technically yes, under very specific conditions:

  • Building permit already obtained
  • 100% finalized and approved plans
  • All materials in local stock (no imports)
  • No client modifications during construction
  • Favorable weather (November-December start)
  • Oversized workforce (cost +15-20%)

Real Frequency: Less than 5% of residential projects in Phuket meet these conditions.

My builder proposes 14 months, is this credible?

14 months is theoretically achievable for:

  • properties less than 250 sqm single-level
  • Flat land without complications
  • Standard finishes (no custom materials)
  • Experienced builder with established supply chain

Recommended Verification: Request references of similar projects delivered in this timeframe + visit these realizations.

What happens if the builder exceeds deadlines?

With well-drafted contract:

  • Delay penalties (0.5-1% contract value/week typical)
  • Termination clause if delay greater than 3 months unjustified
  • Right to schedule audit

Without contractual protection:

  • No effective recourse
  • Endless negotiations
  • Risk of site abandonment

Recommendation: Have construction contract reviewed by specialized lawyer before signing.

Does the architect lengthen deadlines?

Common misconception. The reality:

With independent architect:

  • +10 weeks design phase (before construction)
  • -6 to 10 weeks construction phase (fewer reworks, better coordination)
  • Net balance: -0 to +4 weeks on overall project

Without architect:

  • Apparent savings of 10 weeks in design
  • Loss of 8-15 weeks in reworks/modifications during construction
  • Net balance: +8 to 15 weeks lost

Projects with coordinating architect are statistically delivered closer to initial schedule than “all-in-one” builder projects.


Conclusion: Accept Reality to Better Control It

16-18 months is not a problem. It is the operational reality of quality construction in Phuket.

Promising 12 months does not make climatic, administrative, and logistical constraints disappear. It simply creates frustration, cost overruns, and conflicts when reality catches up with the optimistic schedule.

Savvy investors prefer:

  • A realistic schedule that is respected
  • Budgets that are maintained
  • Total transparency on all stages

…rather than:

  • Unrealistic promises
  • Unanticipated delays
  • Permanent negotiations on deadlines and extras

During your next construction tender, ask this simple question:

“Does your 12-month deadline include obtaining the building permit, and does it incorporate buffers for the monsoon and PEA delays?”

The answer will tell you if you are talking to a salesperson or a transparent professional.

Luxury villa handover Phuket completed construction project realistic timeline KZ Architecture
Luxury villa handover Phuket completed construction project realistic timeline KZ Architecture

Need a Realistic Schedule for Your Project?

We are specialized in local coordination and project management in a tropical climate. We provide detailed, phase-by-phase schedules, based on 20 years of architectural practice and 12 years of experience in Asia.

My Offer

FREE feasibility and risk assessment planning for any residential project greater than 250 sqm in Phuket.
